Written By : Getahun Teferi SAP Functional and Business Consultant Electrical and Computer Engineer Certified SAP Digital Badge in SAP S_4HANA Cloud - Support and Success Essentials for SAP Consultant
Module 1: Project Management Process Overview
Module 2: Project Creation and Maintenance
Module 3: Project Implementation
Module 4: Project Systems Reporting
Appendix and Reference Information
The purpose of the Project Management User manual is to explain the Project Management (PJ) process at UN. The project Project Management (PJ) module is used within the UN to manage voluntary-funded activities, thereby providing enhanced visibility to donors and member-states contributing resources to specific initiatives.
End-to-End High-Level Process

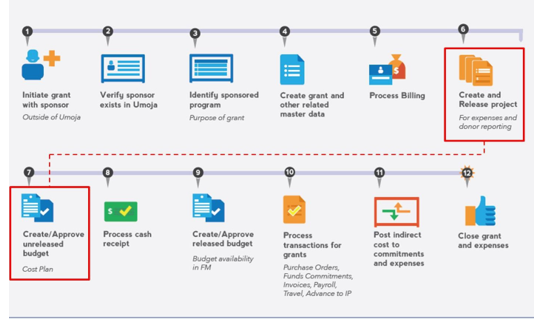

The end-to-end project Grant Life Cycle process can be seen below:
Utilizing the project module enables the UN to:
Enterprise Roles & Responsibilities

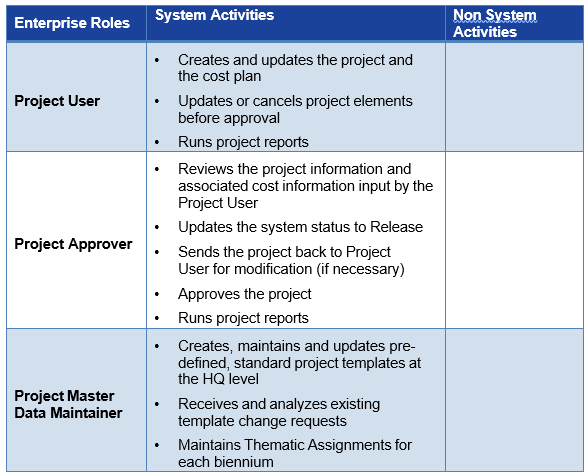

The following EEP Enterprise roles are involved in the Project process:
Key Concepts
This manual includes the following key points: In project, there are two methods of managing voluntary funds. In general, we utilize the following approach to delineate appropriate options, which are highly dependent upon project- type and duration:
Use a Project (Project Management)
Use Internal Order
Note: Both CO objects – Projects and Internal Orders – can be used as cost collectors for investment activities to be capitalized as Assets under Construction (AuCs). Master Data in project To create a project in the project solution, the relevant Master Data elements need to be configured. The Master Data elements involved in the PJ process are:

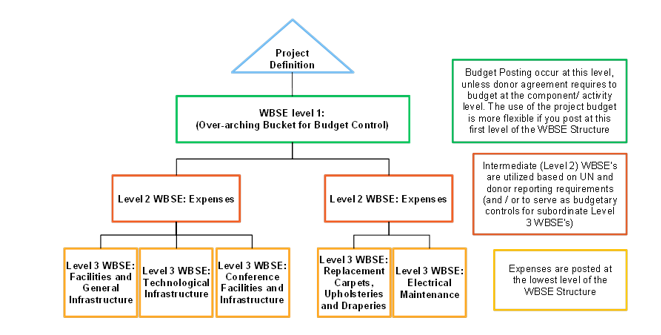

The recommended usage of WBSE's within a project definition is as follows:
Designing WBSE's: General Guidelines
In determining how to create distinct WBSE's within a specific project, it is best to exert the appropriate effort to map out all requirements of the project. Primary drivers of WBSE design are the reporting, milestone and audit requirements established by the UN and the project’s donors:
Given below are the stages in the Project Management lifecycle within project
Module Introduction
In project, every project is linked to a Funded Program to simplify reporting and to allow budget control. The Project Builder is split into different areas, such as structure tree, worklist and template and work area. Project Creation and Maintenance process describes the creation or the re-planning of a project to address an identified need or objective. The key elements of a created project include Window for project structure and entry mask for project definition. Process of how to create a project in project
Data Required to Create Non-capitalized Project Structures
In order to create a non-capital, voluntary-funded project within the project solution, the following information is needed:
Operating Structure within Project
Grants Management
The per-requisite steps While creating a Project are as follows:
Accessing the Project Builder
You can access the Project Builder using the T-code CJ20N. The screen components of the Project Builder are shown below.
Structure Tree Area
The Structure Tree area displays the project objects (Project Definition, WBSE’s, activity, activity element, milestone and document) that you have selected in its hierarchical context. In the Structure Tree area, you can:
Work list and Templates
The Work list and Templates section provides access to the work list and templates.
Work Area
The Work area provides a detailed view of the object selected in the structure tree. You can also directly access overviews of subordinate objects. In the Work area, you can:
You can access the Project Builder using the T-code CJ20N. The screen components of the Project Builder are shown below.
Navigating Tabs in Project Creation
Within the Project Builder, there will be three primary tabs you will access in order to create a project structure and its associated WBSE's. To create a project, data needs to be populated in the following tabs: Basic Data tab: General information about the Overall Project or WBSE. This tab is populated while creating the Project Definition and a single WBSE. While creating a Project Definition, the fields in the Basic Data tab to review and denote are:
Control tab: Identify what type of non-capitalized project it is. While creating a Project Definition, the field in the Control tab to review and denote are:
Note: Once selected, the Project Profile cannot be changed later on.
Assignments tab (WBSE Creation): In creating a WBSE, the fields in the Assignments tab to review and denote are:
Dates tab: In creating a WBSE, the fields in the Dates tab to review and denote are:
Note: Dates entered in this tab should fall within (or equate to) the project start and end dates identified for the overall project.
UN Assignments tab: In creating a WBSE, the fields in the UN Assignments tab to review and denote are:
The Project Creation and Maintenance process describes the creation or the re-planning of a project to address an identified need or initiative.
Business Process Context
The high-level steps in the Project Creation and Maintenance process are as follows:
Note:
Budgeting activities for projects are performed in the Grants Management module of project. There are three steps in managing a project .
Step 1: Create a Project
The first step in managing a project using project is creating a Project Definition, and defining associated key elements. Key elements of a project include project profile, project duration, project type, applicant and person responsible for the project (overall).
Step-by-Step Instructions
The steps to create a Project Definition are as follows:
Note: The Project Builder: User Specific Options screen opens, only the first time you can access this transaction code. Similarly closed screen to proceed
The Project Builder screen is displayed.
The structure of the project you created is displayed. The key elements of a created project include:
3.A window for project structure
4.An entry mask for project definition
5. Enter an appropriate description in the Project Def. field 6. System automatically defaults to the Control tab 7.Select an appropriate option from the Project Profile drop-down list
Note: You cannot switch between tabs until you fill in the required fields.
Project profiles are settings in configuration that have been predefined for specific business processes in the company/organization. These settings define how projects behave in the system. Selecting the wrong project profile may result to incorrect recording of the transaction in the books. For example, the settlement of a project using the capital project profile (ZAA) will ensure that the costs will be recorded as an asset in the general ledger whereas the costs of a non-capital project profile (ZSB) will be recorded as expense. Picture
8.Click the Basic data tab
9.Enter appropriate data in the following fields:
10.Click the Enter icon. The Project Definition ID is automatically created. The project definition and description are displayed in the Project Structure section
11.Click the Save icon
Note: Once you select the Save icon, the project builder will close out the Project Definition Details from the right-hand part of your screen (the work area). You must re- select the Project Definition to continue work within this newly created Project Structure.
12.Once a project definition is successfully saved and created, a confirmation displays in the lower left-hand portion of the status bar
13.The project definition will also display in the Last Project Processed list within the
Work list and Templates component of the Project Builder Note.Since the Project Builder automatically closes out Project Definition details from the work area after you select the Save icon, you may re-access the project you were working in by selecting the appropriate Project Definition within the Last Projects Processed list
Business Process Context
Before you create a WBS for a project, you are required to open the relevant project from the Worklist and Templates component of the Project Builder.
Step-by-Step Instructions
The steps to open a created project are as follows:
Note: You can also open a project by selecting the project definition from the Work list section.
Step-by-Step Instructions
The steps to create a WBS for the selected projected are as follows:
Step 2: Create a Project
The second step in managing a project is creating a high-level Level 1 WBSE.
Step-by-Step Instructions
The steps to create a first-level WBSE are as follows:
The WBSE entry mask is displayed with a default WBSE ID.
Note: Typically, a WBSE is created to include the Acct asst elem. check box. In very rare cases, if you are billing the donor for project-related costs, you may clear the Acct asst elem. check box and select the Billing element check box Picture
Note: The first WBSE created is always the top-level, Level 1 WBSE.
Step 3: Create a Project
The third step in managing a project is creating a lower-level WBSE's. Once the Level 1 WBSE is created, you may add additional WBSE's to the Project based on UN and donor reporting requirements.
Note:
The steps for creating a second-level WBSE are the same as the steps for creating the first-level WBSE, barring one exception. It must be moved to the proper hierarchy location within the Project Structure. The steps to create a second-level WBSE for the project are as follows: 1. Select the appropriate check box in the Operative indicators section Picture
The steps to set User Status to Set and Pass On are as follows:
Note: Each project requires at least one budget control WBSE to receive budget allotments. Defining a budget control WBSE triggers the creation of a funded program in FM. Picture
Once all WBSE's are created, they must be scheduled with respective start and end dates. Every WBSE must have a validity period for financial postings. These dates should fall within the project state and end date range identified within the Basic data tab of the Project Definition. Picture
Step-by-Step Instructions
The steps to schedule WBSe’s are as follows:
Step-by-Step Instructions
The steps to define UN Assignments for each WBSE are as follows:
Note: When you copy a project, there is an issue with default Budget Control WBSE's. It is best to use a template or create it from scratch. A common mistake made on the UN Assignments tab is not pressing the Enter key on your keyboard after locating the appropriate Grant. The subsequent Sponsored Program field will not display applicable options until Enter is clicked.
Note: Within the UN Assignments tab, ensure the Grant, Sponsored Program and Budget Control WBSE are properly identified for each level of the Project Structure. Picture
The steps to validate entries for each of the WBSe’s are as follows:
You may visually review the overall Project Structure of a project by selecting the hierarchy graphic:
Note: Other methods of viewing a Project WBSE hierarchy are available in the Hierarchy Graphic's navigational structure (above). This set of buttons provides additional features, which you may explore when reviewing your overall Project Definition and WBSE hierarchy.
Business Process Context
Project Foundation uses Structure Cost Planning via WBS for project cost planning. Structure Cost Planning via WBS requires manual entry of costs (lump sum amount) against a WBS structure without regard to cost elements, for example, materials, contractual services and staff costs.
Note:
Project cost planning is used for tracking and reporting purposes only; it is not budget formulation for projects. Picture
The steps to access the Change Cost Planning: Initial Screen are as follows:
Next, select the project that requires cost planning. The steps to select a project that requires cost planning are as follows:
The steps to define lump sum amounts per WBSe for a period and calculate the annual value are as follows:
Click the Edit menu. Select the Select > Select All menu item Picture
All line items in the Annual Values section are selected Picture
4 Select the Edit menu 5.Select the Total Up menu item Picture
The Total Up window is displayed Picture
1.Next, you need to update the cumulative view of the plan. The steps to update the cumulative view are as follows:
3. Select the Cumulative option
4.The Copy view window is displayed
5.Confirm the data entered in the Copy view window
Business Process Context
Before releasing the project for budgeting, change the user status to Ready for Release.
Step-by-Step Instructions
The steps to Release the Project for Budgeting are as follows:
> Ready for Release (RFR) menu item
Note:
RAB- Released and Budget
Note:
A whole project can be released by selecting and releasing the Project Definition. This Level 1 Release will change the status of all subordinate WBS Elements.
You must highlight a WBSE with your cursor in order to properly carry out subsequent steps to Set and Pass on a project for budgeting.
There are two ways to release a project.
You can release a project partially by selecting the WBSE’s you wish to release.
Note: This is a manual task. When you select a higher WBSE for release, all WBSE’s under it also get selected for release.
Picture.
When you select a lower WBSE for release, it does not impact the higher WBSE in any way. The higher WBSE is still unapproved and cannot be used to charge items to.
Step-by-Step Instructions
The steps to release the project for budgeting are as follows:
Note: This releases the entire project.
You can also manually release individual WBS elements.
Status > Release
Note: The release within a project structure works top-down. When you release a WBS, all the subordinate ones are also released.
Steps during budgeting a project:
Steps during procurement of goods and services:
Module Introduction
After a project is released or partially released, it is ready for implementation. During this process:
Throughout the process, the actual data generated is compared with the planned dates and costs. If appropriate, unplanned variances are documented. This module includes the following key points:
During Project Implementation, the Project Analyst runs progress reports from the system. Based on the reports generated, analysis is done to determine any schedule or cost variances and to plan necessary measures. For example, stop the project, allocate more budget or update the scheduling. Any activities that are related to the re-planning of the project will be carried out in Project Creation and Maintenance.
The Project Analyst may monitor the project by setting the status of each WBSE or activity according to the degree of progress. The status of each WBSE can be set to any of the following:
In project Foundation, the Project Analyst performs the M&E activities outside project. Since M&E activities are not automated, it is recommended that:
Note:
The results of M&E activities can be qualitative or quantitative. The results are updated in the system as metrics or KPI’s. In the project Foundation, a limited number of KPI’s will be calculated in the system.
The Project Analyst completes this activity outside project. The activities may include the following:
After the status of the project has been set to CLSD, the following processes, outside PS, get triggered depending on the project profile:
This module includes the following key points:
The reports used across Project are:
A Structure report appears as follows: Picture Picture Actual Cost Report The T-code CJ13 is used to view an Actual Cost report: Picture
This report can be viewed after budget is posted on funded program. To be certain of the available budget on a project, it is recommended that report FMEDD be run to see if there is any budget committed in the pre-posting stage. The T-code ZPJPRJBUDBAL is used to view an Actual Cost report. Picture
PicturePicture Picture Picture Module 1: Project Management Process Overview
